Saturday, September 11, 2021

Gorgas Power Plant... Blowdown



Gorgas Steam Power Generating Plant 03/28/16


Faded photo but the stacks were right over my fish



Me on the MV Tuscaloosa, 1973



 Ever since I was a little boy growing up around Bluff Creek on the Mulberry Fork of the Black Warrior River I have been seeing the smoke stacks of Gorgas coal fired power plant.















I worked for Parker Towing co. hauling coal out of Gorgas. They had their own mines back then and produced more coal than they used. It will seem strange when it's all gone not to see those iconic stacks towering above Walker and Jefferson Counties. It was one of the nastiest coal burners in the country. I won't miss it.

On Sept. 09/2021 I went with three of my fellow Waterkeepers to document the blasting of the old Gorgas power generating plant. It was a good thing to see.


This power plant was the dirtiest, as for emissions anywhere in the state and 7th dirtiest in the country. For several generations this plant has been spewing coal ash, dust and harmful greenhouse gasses since 1917. It was time to take it down 20 years ago.






Goodbye Gorgas. You will not be missed.

Friday, September 3, 2021

STOP WORK ORDER finally enforced!

STOP WORK ORDER finally enforced!

STOP WORK!


The City of Tuscaloosa recently issued a “Stop Work Order” to the Quick Trip Corporation facility located at the intersection of Buttermilk Road and I-59. Stop work order means just that. Stop working on anything except mitigating the recent violations and offsite impacts to residents and businesses located in the path of their mud flow. That is unfortunate for the contract workers who have to go home because the general contractor refused to follow the guidelines. As usual the QT folks are telling nearby business owners that it is my fault their work has stopped. If the Quick Trip Corporation contractors had performed as prescribed in the city and state permits, there would have been no need for Friends of Hurricane Creek to ever file the first complaint. It was negligence on the part of the polluter but also the City of Tuscaloosa building inspections and ADEM for standing by watching with blinkers on it seemed. That is until I showed up on site with a camera.

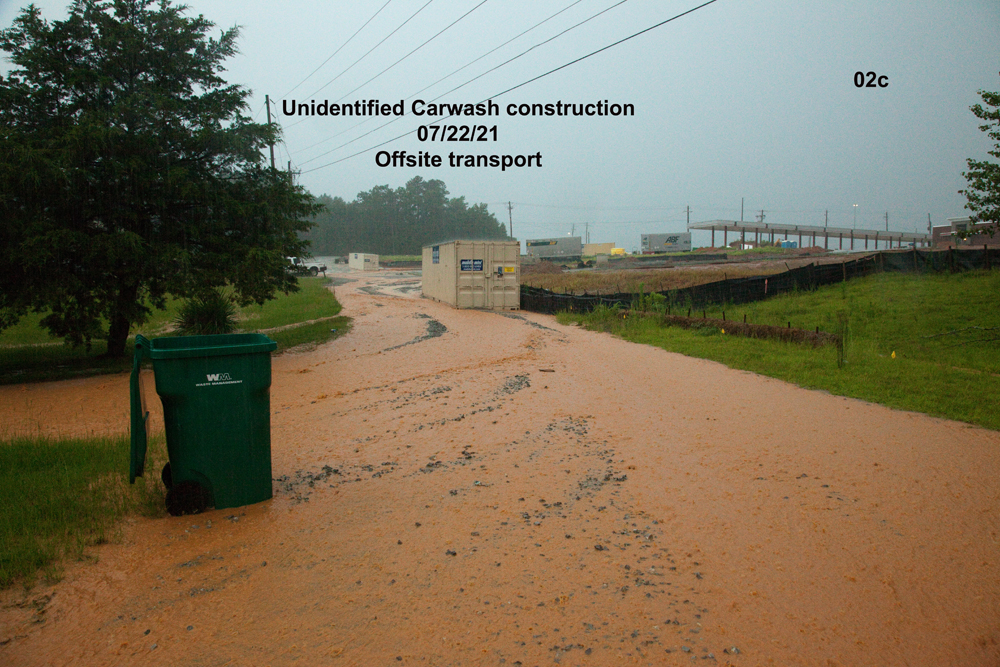

Once I made a public post showing the offsite flooding of residential property and the deposit of tons of sediment onto state and county right of way things began to improve slightly. When Tuscaloosa finally took action in the form of a SWO, improvements began the very same day. That proves what I have been saying for over 2 decades. Warnings do not deter bad behavior. Enforcement where the developer feels the effects at the bottom line in the budget gets immediate response.



It should not take public humiliation and outcry to make the enforcement agencies to step up and do their jobs but that seems to be the only way to get help for tax paying citizens being hit with mud and accelerated runoff from a poorly planned and implemented construction site every rain event.

 When a company like QT corp. and McCrory sign on to a permit and then ignores the stipulations to protect the environment then they should be stopped. That is the primary responsibility of the inspectors who visit the site on a regular basis. If local inspectors do not act, then ADEM is the second line of defense. It this case I can document, both lines of defense failed the citizens. It is not a singular event. There have been many such sites in and around Tuscaloosa, which have not held accountable. I personally believe that the city inspection department has far too chummy a relationship with violators. Many corrective measure letters were sent from the inspection department but no real improvement was seen until the city engineer, Jarrod Milligan showed up and walked the site with the inspections division head, Colby Mixon.


Colby Mixon

Construction Manager

Office of City Engineer

Infrastructure & Public Services



It was obvious that Mr. Milligan was unaware of some of the issues on the site. For every problem I pointed out, Mr. Mixon seemed to know about it and have “reasons” for why it occurred without stopping the work earlier. I personally found his reasons to sound more like excuses for the violations. For instance, he knew the sod that was supposed to be used for stabilization rotted and was hauled off of the site. He knew about the repeated erosion control measures that were not installed and or maintained.


He knew the drainage along I-59 was a failure and made the excuse that there was an elevation problem. I agree. The issue has existed for almost a year but Mr. Mixon never thought it was important enough to address until Mr. Milligan, his supervisor was on site with us.



A major set of issues which Mr. Mixon was aware of has been the chronically failing best Management Practices (BMPs) along the I-59 corridor. Simply put, there have been none since the slope was scraped bare. It is to be a service road leading to Gulf States Auto sales. No inspector worth being paid could ignore that.

As it stands now there is no quick fix for drainage issues located at the north western most section of the permit. The inspectors for the city should have picked up on this from the beginning and made them take the proper steps to mitigate the problem. They knew about it and explained that they had some elevation issues. No joke! Water will not run up hill without external pressure such as a pump. That’s not my opinion, that’s facts!

Entrance to Gulf States Auto sales during rain.
The owner of Gulf States Auto sales is being hurt from a business standpoint. I have personally redirected several of their customers to the entrance of the day. It changes quite regularly. They deserve an adequate entrance, which does not impede commerce. A perfect permanent resolution to the issue would be to make the service road a priority, Get the ALDOT permit and build the road! The polluter has submitted no sediment loss calculation as directed in the ADEM NOV. From what I have seen and documented there has been several inches of sediment loss over a very large area, which until yesterday, 09/01/21 had no BMPs at all. The sediment load in Cottondale Creek is quite visible even though Mr. Evan Roberts of ADEM claimed the creek is not near the site. I have walked it out. It’s about 175 feet from the ALDOT flume ditch, which QT is using as an unpermitted discharge point.




I am getting blamed for slowing down the work progress. I completely disagree. The permit had a set of state and local guidelines QT was required to follow. They did not. The city inspections department had an obligation to take deterrent action to stop the flow of mud. They did not. It was a combination of irresponsibility by all concerned.



I believe the only way to mitigate this now is to create a permanent retention basin at the lower most section and apply for a discharge permit from Alabama dep. of transportation, ALDOT. The process of getting an ALDOT permit should have been built into the plan submitted to the Tuscaloosa Planners. From the surface it seems that the planners do not take in such matters. A developer submits a plan and without significant public opposition it is passed regardless of its protective value to the surrounding community or so it seems. Again, this is not a stand alone problem. It has been repeated many times on many such development sites permitted by the city of Tuscaloosa. I have thousands of files ranging back to 2007 when FoHC first engaged the city over storm water runoff.



Valley Lake Rd. The city "forgot" to notify the county about work
There was an agreement between the city and Tuscaloosa Co. that the city would notify the county engineers when construction began. In an email sent by Co. Civil Engineer Katherine Parris she asked why the city had not informed them of construction beginning. The response was (paraphrased) we’re sorry. We forgot! Anyone who “forgets such an important part of the construction activity should no longer be on the Tuscaloosa employee roster!  What administrator would allow such negligence to continue on their payroll?

When the local and state agencies do not enforce the permits that they, themselves write then it is up to citizens and non-governmental organizations like Waterkeepers Alabama to stand up and protect our waterways as well as the citizens who enjoy the use of our waters

ADEM Director Lance LeFleur

ADEM Director Lance LeFleur recently penned an Op-Ed stating, “It takes more than lawsuits to protect Alabama waters” This is one time I fully agree with the Director. It takes local and state agencies dedicated to protecting the water and air instead of shielding the polluters who pay for permits.


 We as WaterkeepersAlabama members do not sue for the fun of it and we don’t make money from suing. In most cases it costs the organizations much more than you might think. If the Alabama Department of Environmental Management (ADEM) did their job with the due diligence it requires, we would not have to take action at all.

 Unfortunately here in Alabama what we have witnessed for years is that our state agency, Alabama Department of environmental management, (ADEM) appears completely impotent when it comes to enforcing the Clean Water Act. Over the time I have been an environmental activist I have heard more than one director say ADEM is not here to enforce to clean water act ADEM is here to issue permits. I completely disagree. If ADEM and or a local host government issues a permit to disturb ground then that entity is responsible for enforcing the stipulation of the permit as granted. The environmental conditions included in every disturbance permit are just like a stop sign at a corner downtown to prevent wrecks. If I run that stop sign and a cop sees me I can expect to be pulled over, cited, expect to pay a fine, and possibly lose my license. There’s no difference between those stop signs and the environmental stop signs incorporated into every permit, designed to protect the environment. They are there to protect the environment but also the citizens downstream who are impacted by the facility. Engineering firms who do not adequately report on the ground conditions and falsely represent compliance should be sued and lose their licenses. The permit, if properly enforced should have stopped this Quick Trip wreck from ever occurring.



Personally I believe this would be low hanging fruit for a civil case against the developer, his contractors as well as the city of Tuscaloosa for negligence.

STOP WORK ORDER ignored







A stop work order was issued by the city of Tuscaloosa finally! It was issued Fri. afternoon, 08/27/21 at 03:48 PM. At 5 PM they were still working!!



As of Saturday morning they were still working when the city showed up and finally issued a stop work order again and waited until all contractors had left the job site.  The following complaint was filed with ADEM. So far, all ADEM has done about the NOV is issue but "consider" more action. Meanwhile the city has taken meaningful action.







08/29/21

Please accept the following complaint against the Quick Trip construction project located at the intersection of Buttermilk Road and I-59 in Tuscaloosa County. N 33.17065 W 87.44712 NPDES permit number ALR10BHQ0



This report will cover 3 days at the site. A lot happened in the period between 08/26/21 and 08/29/21.




I visited the site on 08/26/21 and found construction activity going on as usual in spite of Mr. Ensor claiming all of the area would be stabilized and sodded beginning last Monday. NO evidence of that can be found. There are several acres of the site with no cover at all in places subject to severe eroding.




The drop inlet near the Hargrove roan area has still not been addressed. The silt fence surrounding it is clogged and with holes. Mr. Ensor specifically said the area would be sodded and the silt fence removed last Monday, Aug. 23. It is now Aug. 29 and it still hasn’t been done. The BMPs below that have been failing chronically since I first reported in late July. Just below that QT has installed a gravel ramp several inches deep and about 20 x 20 feet. It has already begun cutting in only a half-inch rain. What happened to stabilizing the entire area? ADEM needs to take that into consideration during the enforcement and penalty assessment.



In the response to the NOV.



QT Engineer stated, “Per discussion with McCrory Construction, the site will continue to be permanently stabilized on Monday, August 23. Everyone understanding of the expediency in which the State’s concerns need to be addressed and have already performed multiple BMP installations/alterations to prevent sediment from discharging downstream.“ “Recommend to sod area around inlet immediately and remove silt fence. Silt fence appears to be clogged and water is overtopping berm and running down Valley Lake Road. All bare soil areas shall be stabilized expediently. This will help prevent erosion, aid in infiltration, and slow surface runoff.”



NO sodding has taken place. I did see a few straw mats rolled out but no repairs to the BMP issues reported. When asked why they were using straw mats instead of sod, the adjacent landowner was told that they could not get any sod. I have to call that one a willful campaign of misinformation.

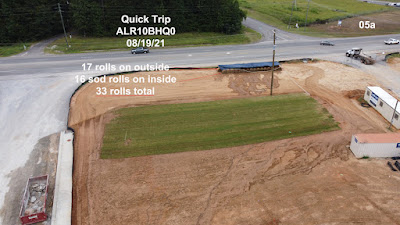

On 08/16/21 when Mr. Ensor was here there were at least 30 rolls of sod on site. NONE were used. All are now gone. Hauled off I would guess because not a single one was rolled out! The hay mats are better than nothing I guess but not by much. This kind of activity needs to be taken into consideration during the enforcement and penalty assessment.



08/27/21 I visited the site after there was a ½ inch rain and as usual, the area surrounding QT was inundated with mud and water offsite.



The newly installed gravel ramp had already lost a few inches of gravel down the road and again there was a heavy load of sediment offsite on private property across the street! Many of the BMPs still had large holes and were not installed properly.



Much of the site is still bare. Not even covered with hay.








The pond device for lack of better term is not working and was never constructed properly. Even today, 2 days after any rain it is still belching red water from the pipe and under the failed BMPs into Valley Lake Rd, then into the lake.

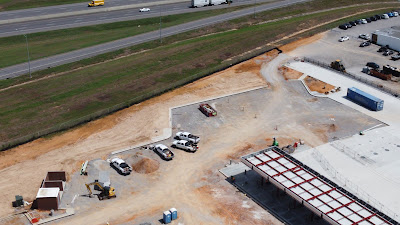

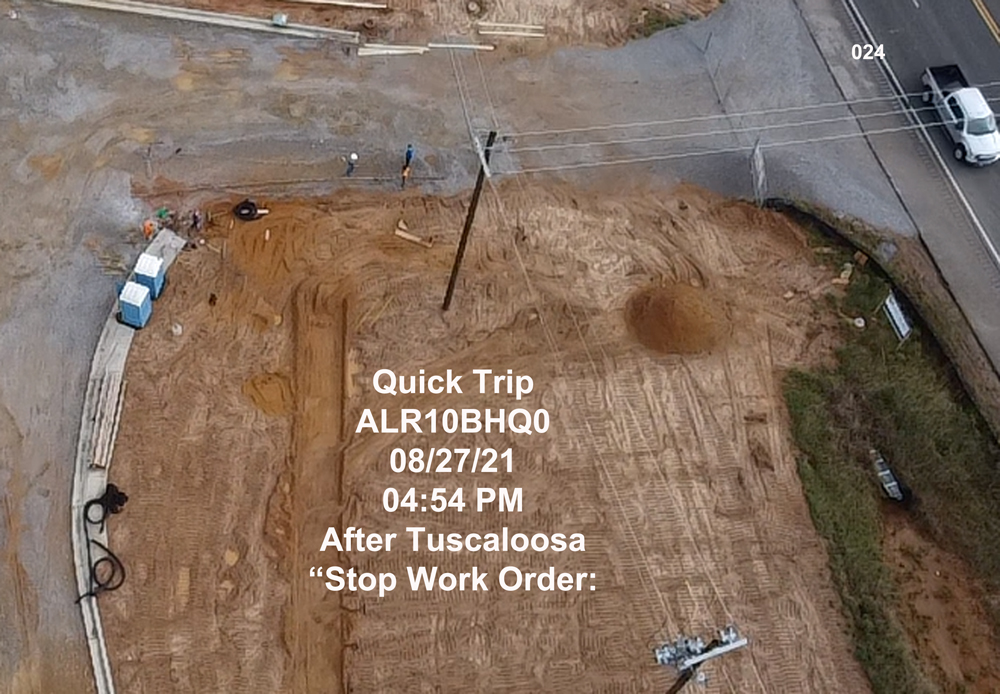

At 11:28 AM, 08/27/21, I photographed Tuscaloosa City officials onsite. By 03:48 PM a “Stop Work Order” was issued. All construction activity except working on BMPs was to cease. At 04:54 I found them still building a concrete form for the front entrance. I notified Tuscaloosa.


I returned Saturday, 08.28.21 and found them still digging ditches and working on everything except BMPs and stabilizing the site. Again, I notified the city and within 30 minutes an inspector showed up and stopped all work. He personally stayed until all workers left the site.



Sun. 08/29/21. The site still has about 1/3 of its footprint without cover. BMP have been somewhat attended to. I can’t call it repaired. They patched some of the holes and kicked up some dirt on other places. Additional silt fences have been installed but many are not properly set up.

ADEM needs to take that into consideration during the enforcement and penalty assessment.



This noncompliance is chronic. Even ADEM can’t turn a blind eye to the lack of concern for the NOV from ADEM, 2 Stop Work Orders from the city, and a rather flowery response from their engineer, which has not proven to be true. In spite of all of that, as
Hurricane IDA slams into LA. on its way here, no preparations have been made to be ready for the 3 – 5 inches predicted to hit us here.

 Tuscaloosa City officials showed up in the rain and saw firsthand the problems created by the lack of enforcement. I can already hear the cries of “It was an act of God” “It rained a lot so “”Upsets”” happen”. Under normal circumstances, that might be true. In this case it doesn’t hold up. If you have not installed your BMPs properly and maintained them as prescribed then any upsets and offsite impacts should be considered intentional or at least gross negligence. ADEM needs to take that into consideration during the enforcement and penalty assessment.
